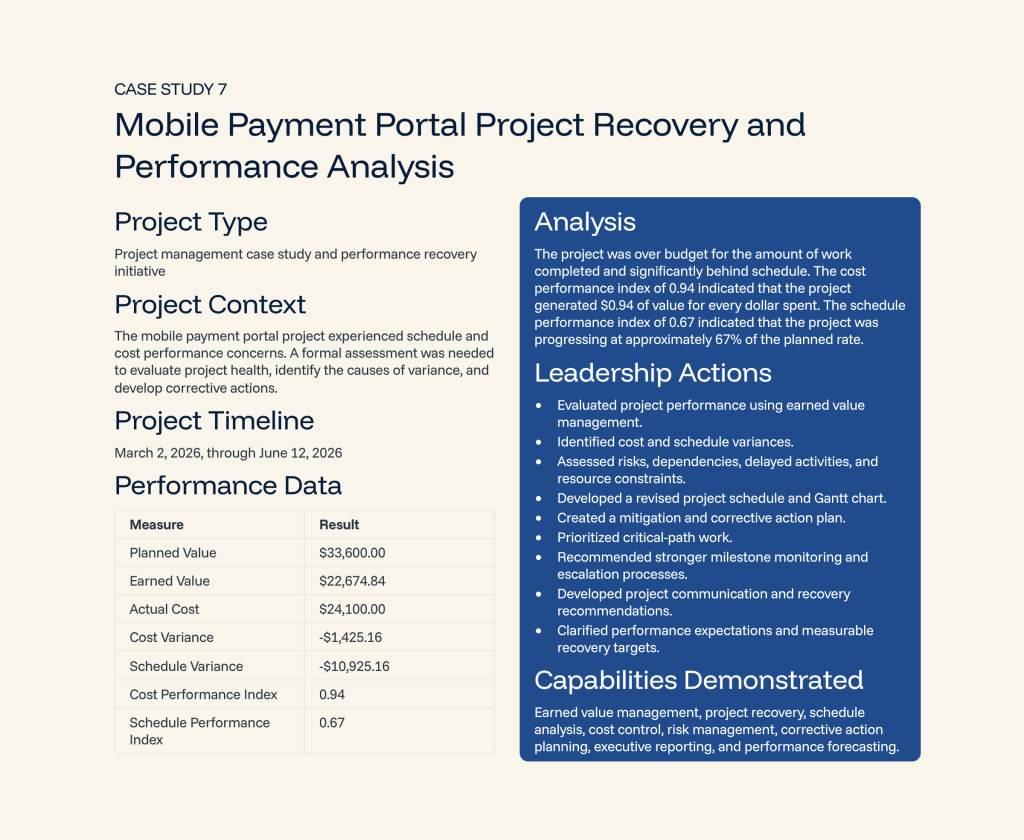

Mobile Payment Portal Project Recovery and Performance Analysis

Project Type

Project management case study and performance recovery initiative

Project Context

The mobile payment portal project experienced schedule and cost performance concerns. A formal assessment was needed to evaluate project health, identify the causes of variance, and develop corrective actions.

Project Timeline

March 2, 2026, through June 12, 2026

Performance Data

Measure Result Planned Value $33,600.00 Earned Value $22,674.84 Actual Cost $24,100.00 Cost Variance -$1,425.16 Schedule Variance -$10,925.16 Cost Performance Index 0.94 Schedule Performance Index 0.67

Analysis

The project was over budget for the amount of work completed and significantly behind schedule. The cost performance index of 0.94 indicated that the project generated $0.94 of value for every dollar spent. The schedule performance index of 0.67 indicated that the project was progressing at approximately 67% of the planned rate.

Leadership Actions

  • Evaluated project performance using earned value management.
  • Identified cost and schedule variances.
  • Assessed risks, dependencies, delayed activities, and resource constraints.
  • Developed a revised project schedule and Gantt chart.
  • Created a mitigation and corrective action plan.
  • Prioritized critical-path work.
  • Recommended stronger milestone monitoring and escalation processes.
  • Developed project communication and recovery recommendations.
  • Clarified performance expectations and measurable recovery targets.

Capabilities Demonstrated

Earned value management, project recovery, schedule analysis, cost control, risk management, corrective action planning, executive reporting, and performance forecasting.
